Project Tracker
2751 E Oakland Park Blvd
PM
Critical Path Position
0% 0/34 steps
Next Blocker
Critical Issues 0 open
Cost Burn
$0
of $25,000 target
$25,000
remaining
0% Hard cap: $35,000
Next Three Actions
1
Send briefs to Dan, Marcos, IDB tomorrow morning (Tue 4/27 8:00–8:10 AM).
2
Phone calls 9:00–9:30 AM to confirm receipt and request earliest walkthrough availability.
3
Request Thursday AM joint meeting with Dan + Marcos before Thursday afternoon/evening meeting with IDB — so subcontractor inspection findings inform initial engineer drawings, formally request ADA Exemption, and confirm total required scope, project cost, and initial timeline ASAP.
Recent Discussion VIEW ALL →
Critical Path
Briefs in hand → legal Grand Opening · 34 steps · 6 gates · 6 inspections
Critical Checkpoints All Phases
Items that gate the permit / opening
ADA Exemption — critically urgent. Two defenses ready: disproportionate cost (20% rule) + technical infeasibility (22 SF cannot fit 60" turning radius). File with permit application.
Source: BEACON_MASTER_2751OPB · FBC 2023 · NFPA 101
BSIP 50-Year Recertification — status UNKNOWN. Building is 1966 (60 years). 40-year recert was completed 2010 (PM-10040010). 50-year would be due 2026. Catastrophic if overdue. Call FTL Building Services to verify.
Source: BCPA · LauderBuild PM-10040010 · BEACON Run 3
Kratom 7-OH compliance audit — Florida emergency rules 2ER25-3 + 5KER26-1 (March 2026, EFFECTIVE NOW). Pull COAs from HNR Distribution for ALL current kratom retail SKUs. Confirm every product <400 ppm 7-OH+isomers (dry weight). Confirm every label lists 7-OH ppm on dry weight basis. Stop-sale risk if non-compliant. Phase 1 — applies today.
Source: 2ER25-3 (FL AG emergency rule) · 5KER26-1 (FDACS emergency rule, Mar 2026)
FBC Occupancy Group B — preliminary. 38–45 occupants at 15 SF/person. Under 50 threshold = no sprinklers, no alarm, single exit acceptable.
Source: FBC 2023 §303.1 · NFPA 101 calculation
Energy Code C503 — required. Change of occupancy. Calculation owed by Jim Diehl as part of stamped drawings.
Source: FBC Energy Code C503
Scope of Work — Phase 1 Build
Per-trade scope summary. Subs assigned where formalized; informal labor scoped only.
DEMO
Abandoned bathroom partition demolition
Matt/Freddie scope · informal labor
DEMO
Mirror-wall removal (CI-05) — both E + W walls, gym-era infrastructure
Matt/Freddie scope · specialty handling required
FRAME
Frame closures for shared-wall openings + new partitions per Jim Diehl drawings
Matt/Freddie scope · informal labor
DRY
Drywall hang + tape/mud + screw inspection prep
Matt/Freddie scope · informal labor
PLUMB
Plumbing rough-in — handwash + 3-comp + mop sink (existing bathroom turn-key, no rough needed)
Dan Berg · Oakland Park Plumbing
ELEC
Electrical rough-in — kitchen circuits + lighting · CI-03 + CI-04 evaluations
Marcos Coelho · S&R Electric
FLOOR
Acid stain concrete — carpet already removed, subfloor exposed
Wes · Great Finishes (E-01)
FINISH
Paint, signage, trim
Kenny + Anthony · finishes labor
CEILING
Drop ceiling — disturbed state by design until past inspections, then close walls/ceilings
Per Nick directive · 4/27
Permit Dependencies
Three permits, parallel tracks
FTL Building Permit — drives critical path. Submitted online via Accela. Revision rounds typical 7–14 days each.
Source: FTL DSD · LauderBuild Accela portal
FDACS Food Permit (Part 1 — beverage service) — parallel track. Submit ~14 days before opening. Settlement B58902 PAID IN FULL.
Source: Nick confirmed 4/26 · FDACS settlement records
Tobacco Retail (ABT-6028) — parallel, $50, 2–4 week processing. Does not delay anything.
Source: DBPR ABT · Session 4/26
FDACS Part 1 Standards (beverage service)
ANK = Part 1 (brewed kava + tea + coffee = beverage service), NOT Part 2 (prepackaged only)
Smooth nonabsorbent floors → acid stain concrete via Wes (Great Finishes). Coved at wall/floor junctures in mop areas (FDACS Part 1 §5).
Source: FDACS Min Construction Standards Part 1 §5 · E-01
Handwash sink — owned, needs rough-in. Hot+cold water through mixing valve (FDACS Part 1 §7-8).
Source: FDACS Part 1 §7-8
3-compartment sink — owned, needs rough-in. Indirect plumbed via air gap or air break (FDACS Part 1 §9).
Source: FDACS Part 1 §9
Mop sink — required (FDACS Part 1 §10). Hot water not required.
Source: FDACS Part 1 §10
Adequate ventilation — no cooking equipment, no specialized exhaust required. Existing 3-ton HVAC (PM-00090327) confirms baseline.
Source: FDACS Part 1 §13 · PM-00090327
Toilet room separation — existing bathroom is enclosed and self-closing. Cannot open directly into food prep (FDACS Part 1 §4). Verify door swing in proposed plan.
Source: FDACS Part 1 §4 · proposed floorplan
Property Identity
Address
2751 E Oakland Park Blvd, Fort Lauderdale, FL 33306
Lease §1.1(b)
Folio
4942-24-03-0050
BCPA
Year Built
1966
BCPA
Suite SF
~873
Lease
Building SF
4,849
BCPA
Construction
CMU / Reinf. Concrete
BCPA
Zoning
CB
BCPA
Flood Zone
AE
FEMA NFHL
Assessed Value
$851,560
BCPA 2026
Existing Floorplan

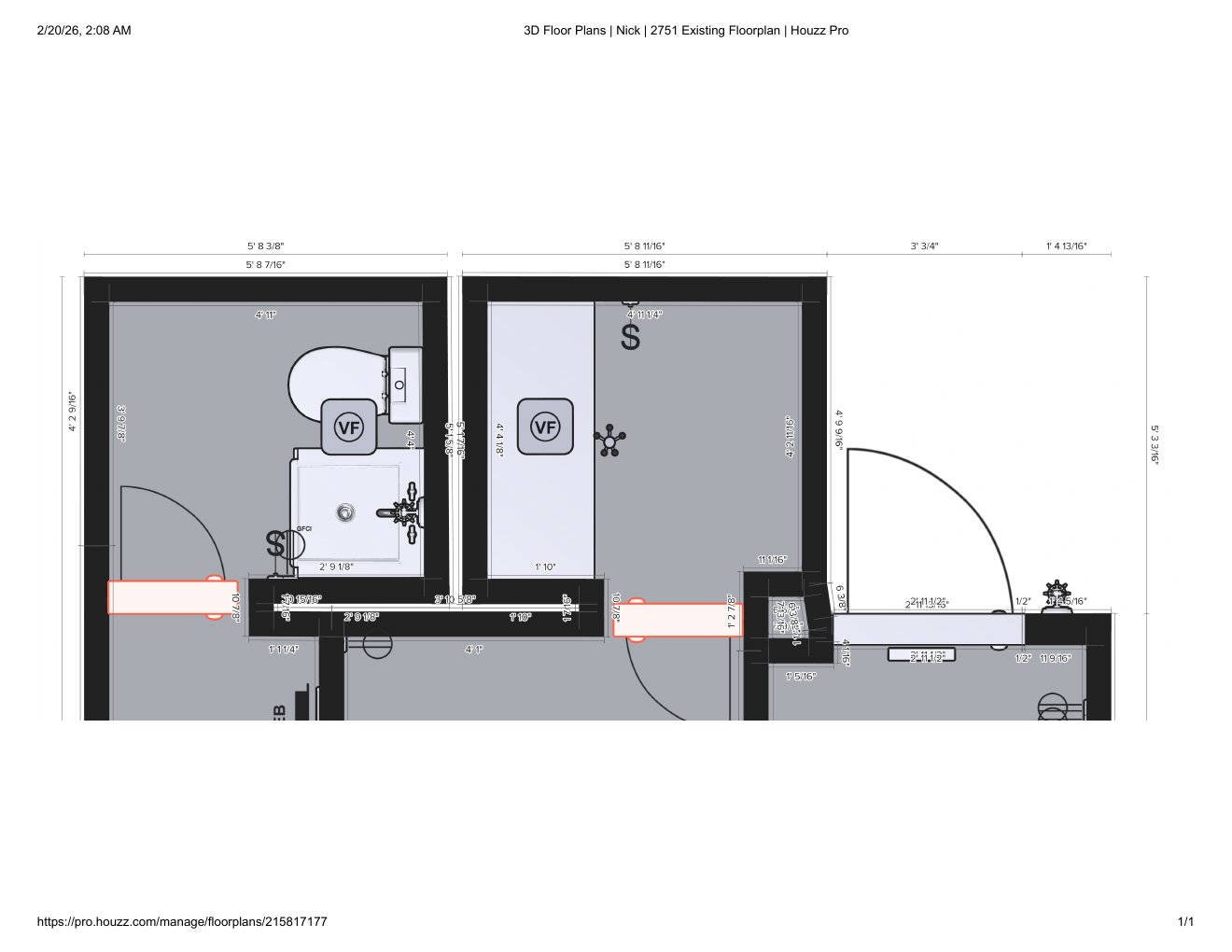

Existing — Full Layout
Full Layout (with measurements)PDF ↓

Existing — Overview
Overview (clean)PDF ↓

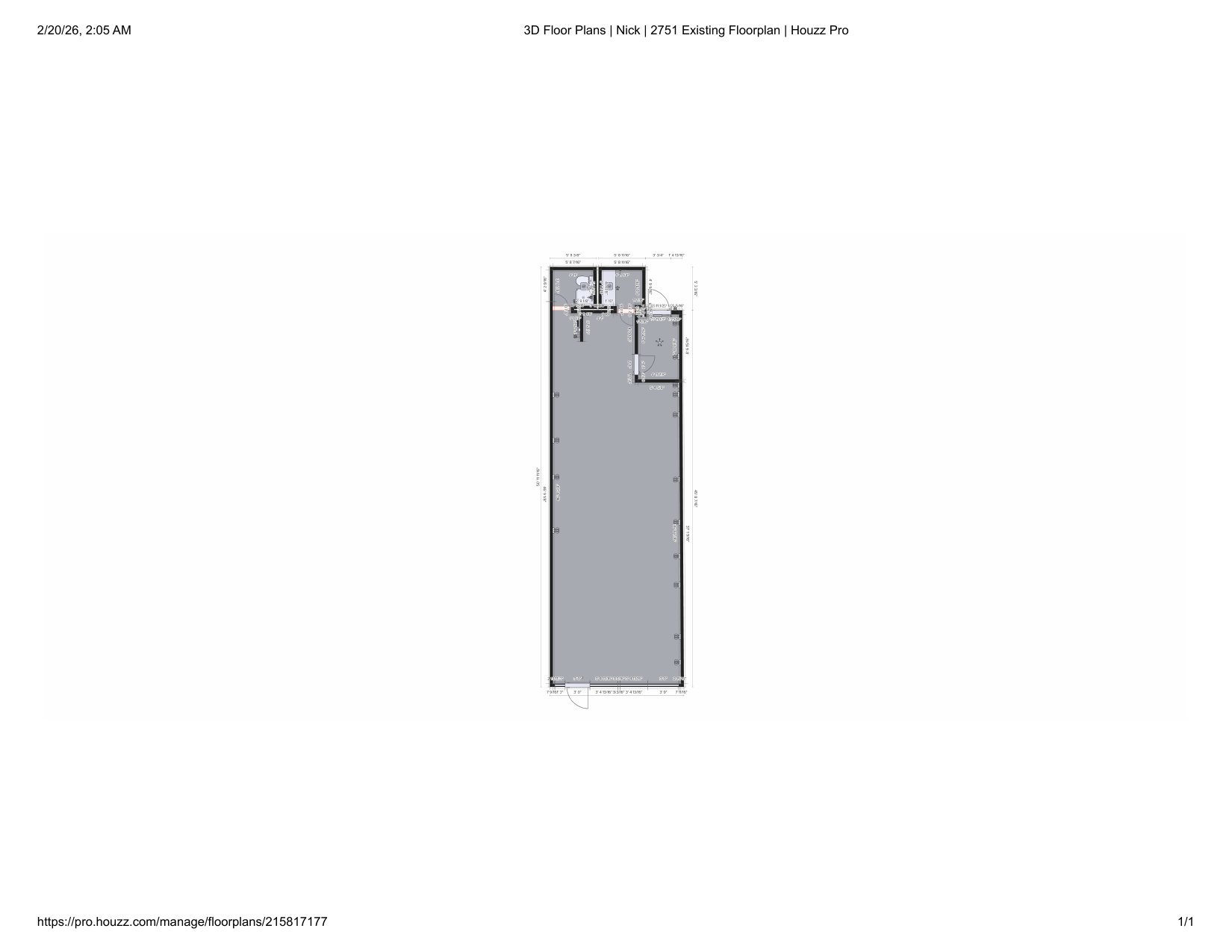

Existing — Front Doors Detail
Front Doors DetailPDF ↓

Existing — Bathroom + Office
Bathroom + Rear OfficePDF ↓

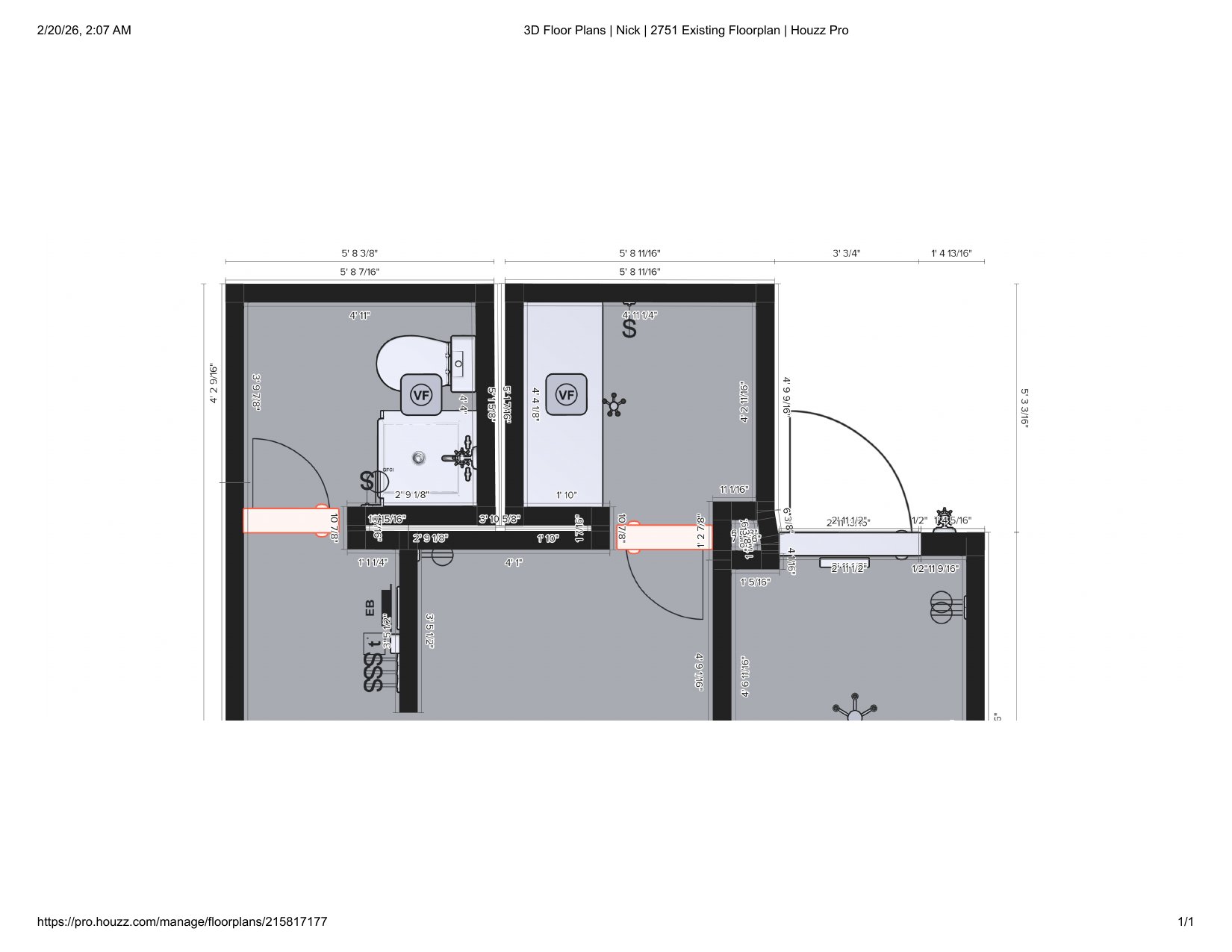

Existing — Bathroom Detail
Bathroom DetailPDF ↓

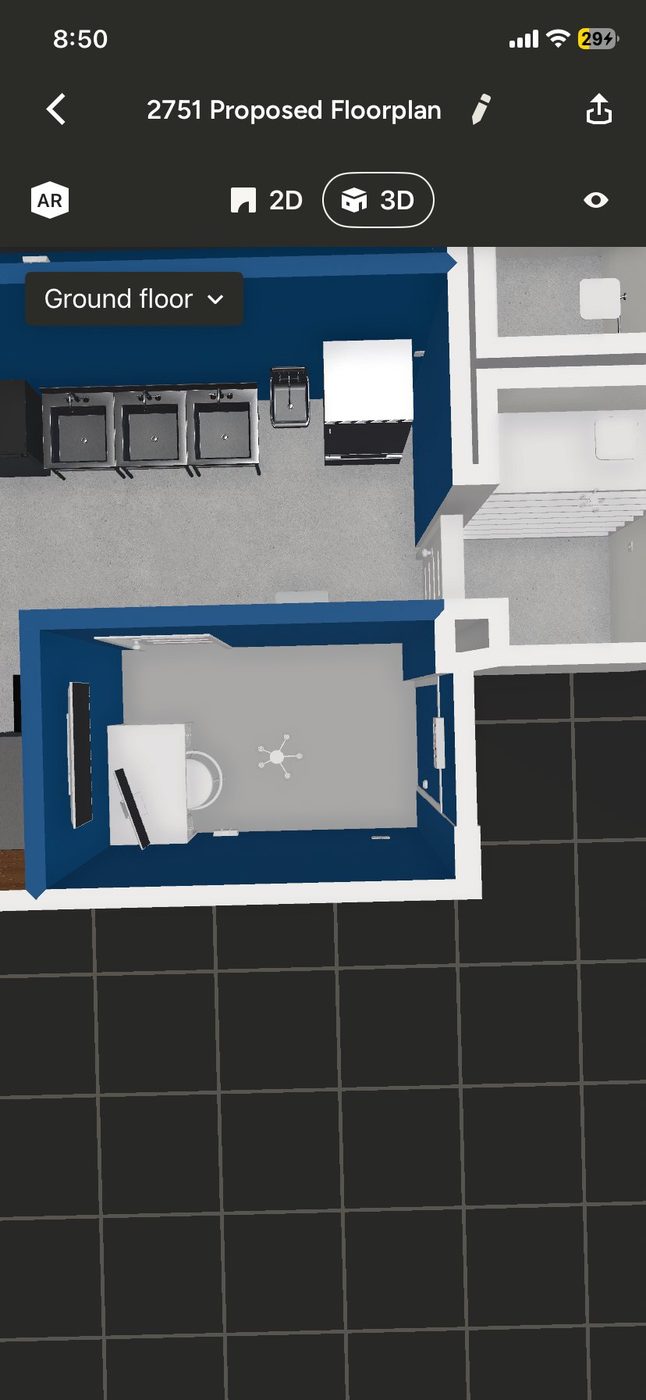

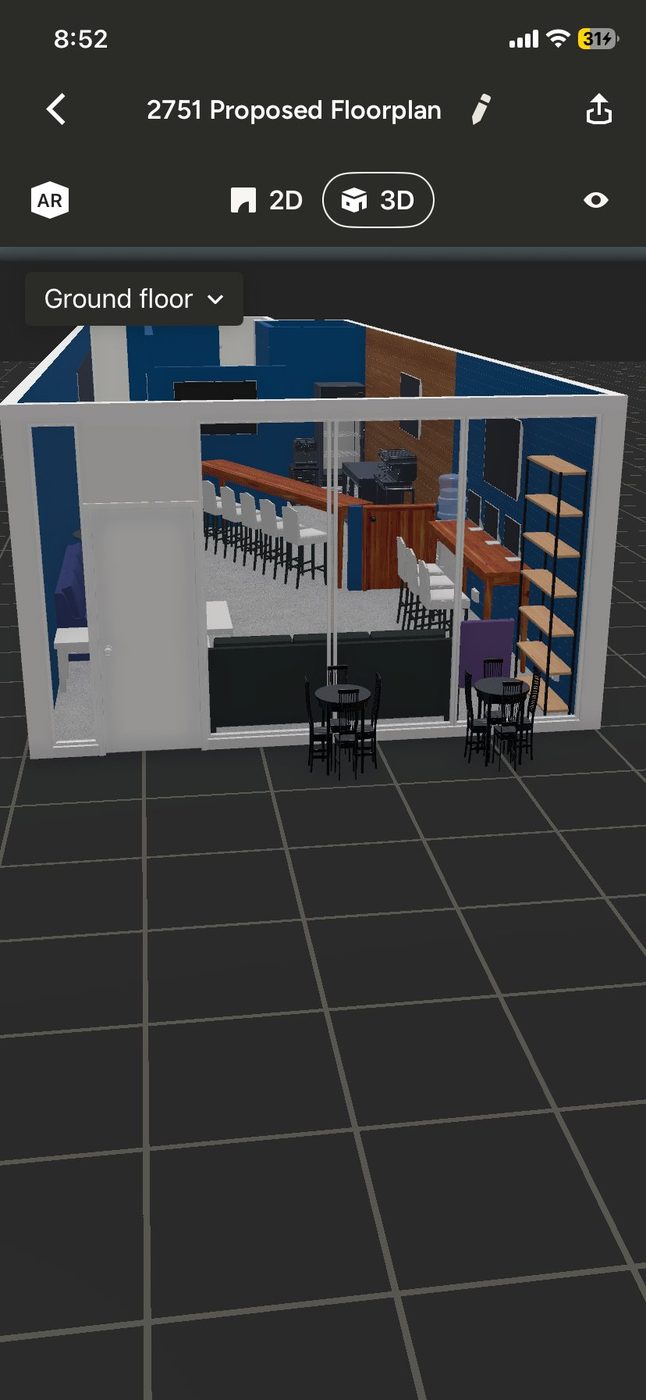

Proposed Floorplan

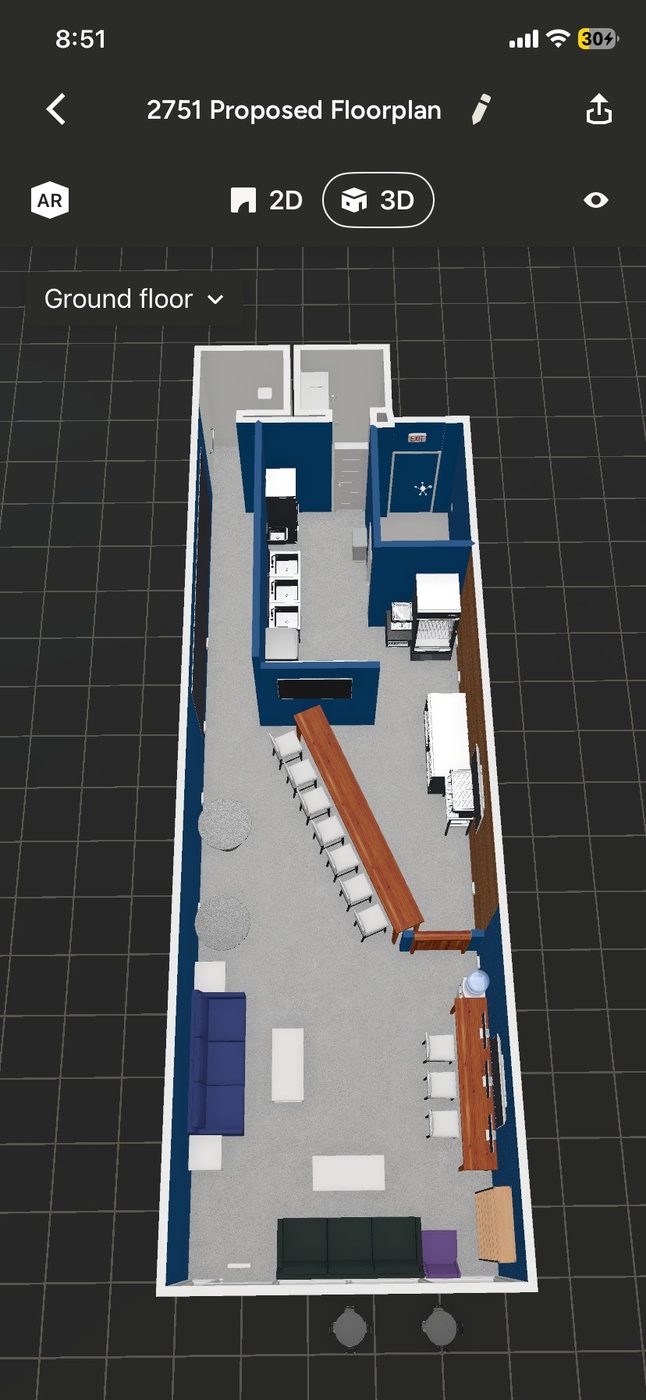

Proposed — Full Layout
Full Layout (with measurements)PDF ↓
Proposed — Overview
Overview (clean)PDF ↓

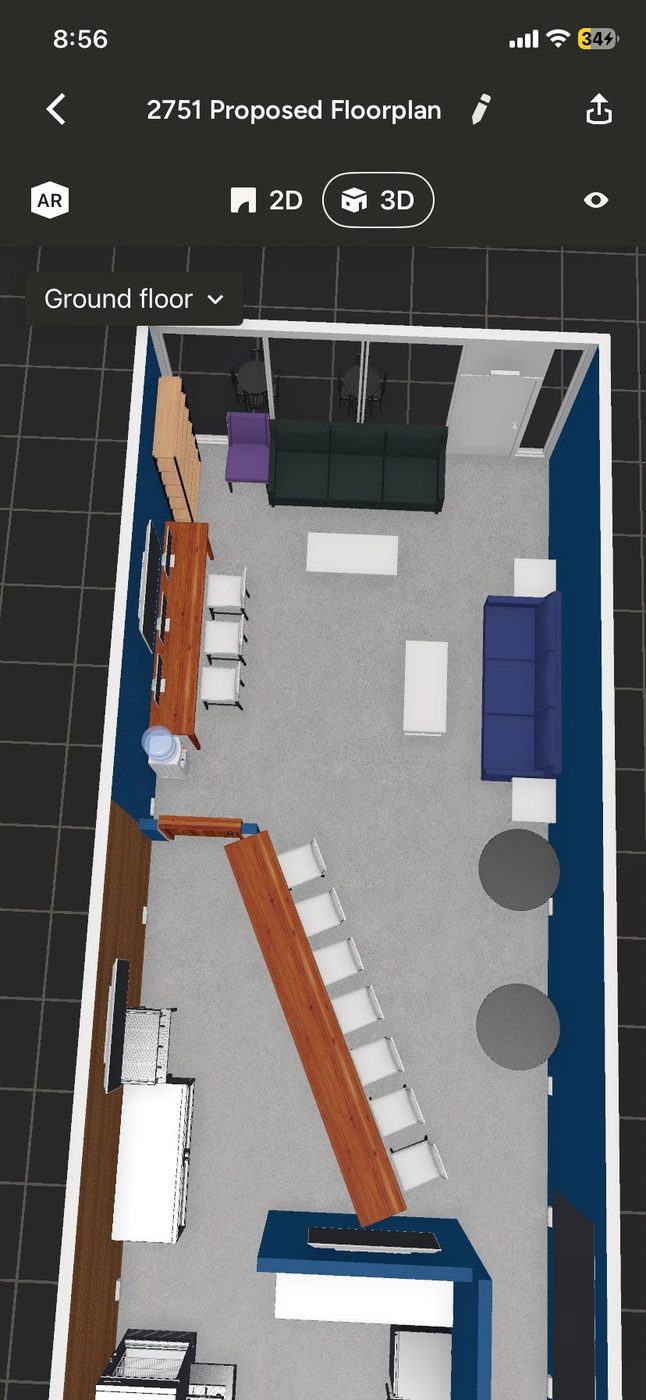

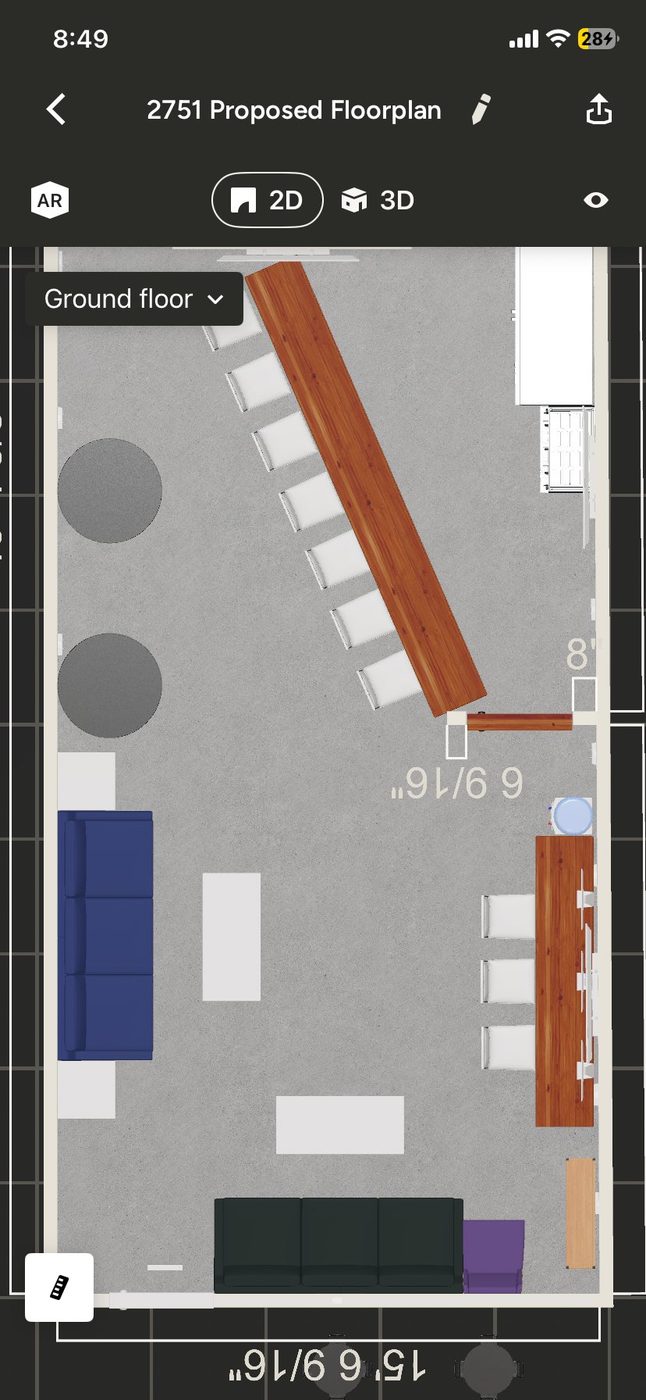

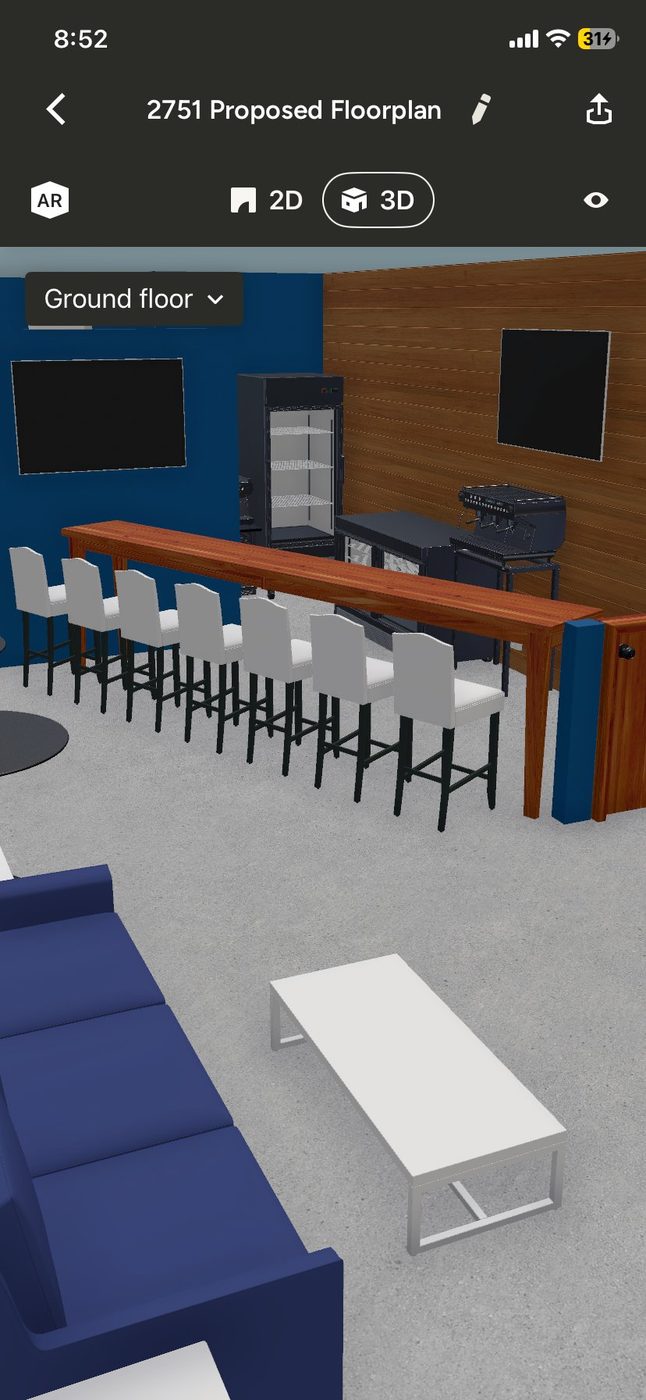

Proposed — Kitchen / Service
Kitchen / Service AreaPDF ↓

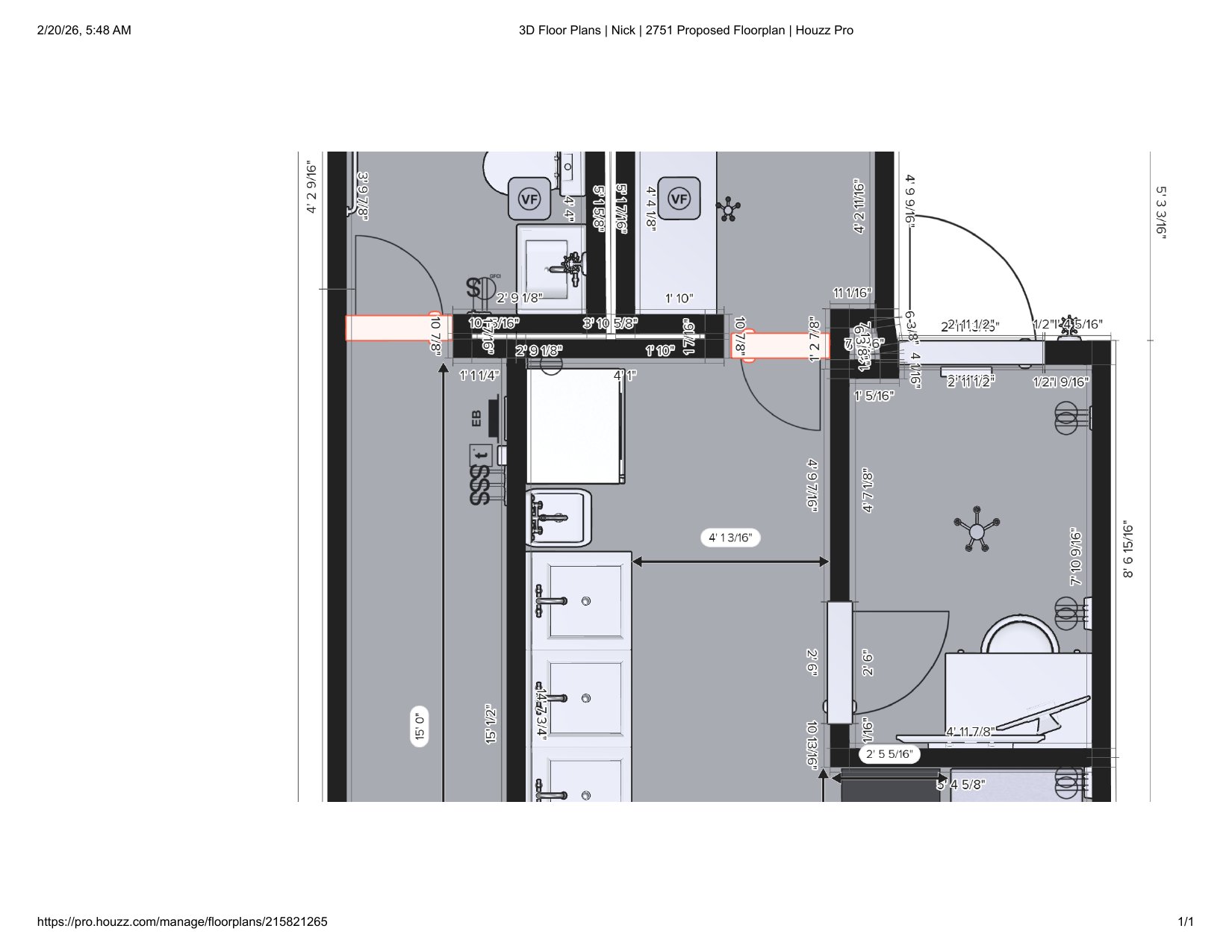

Proposed — Kitchen Detail

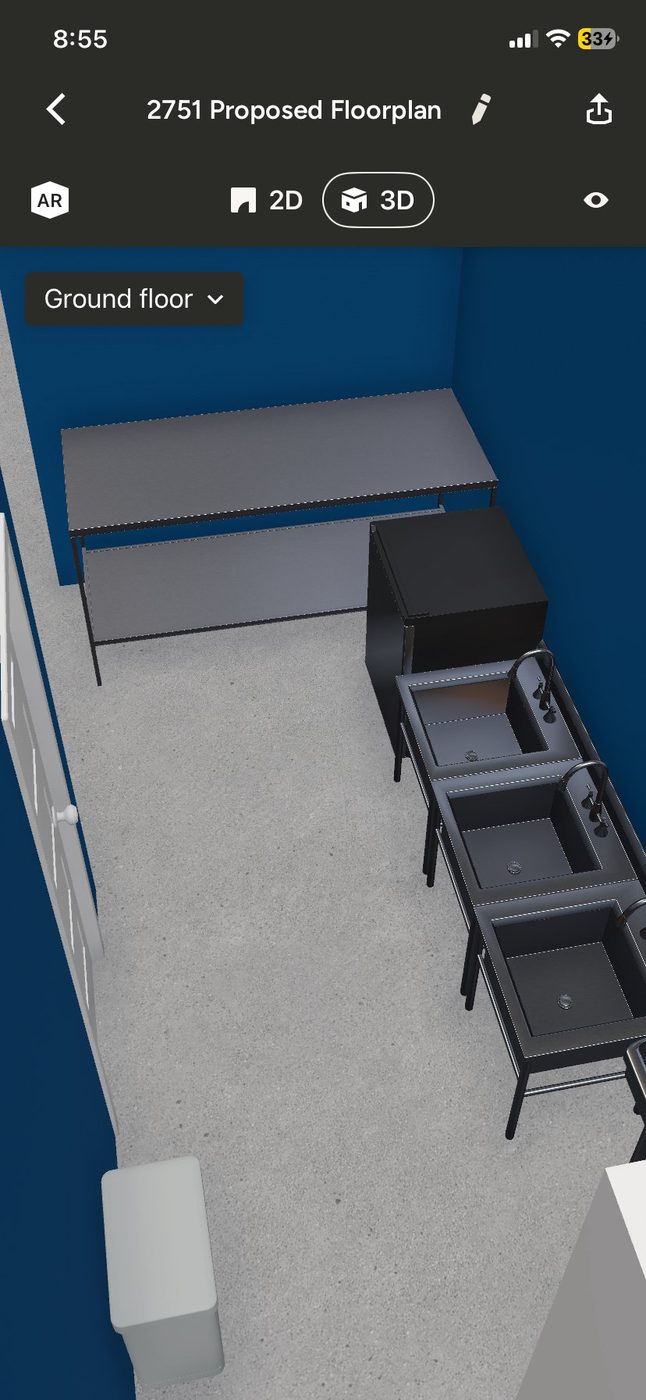

Kitchen Detail (sinks)PDF ↓

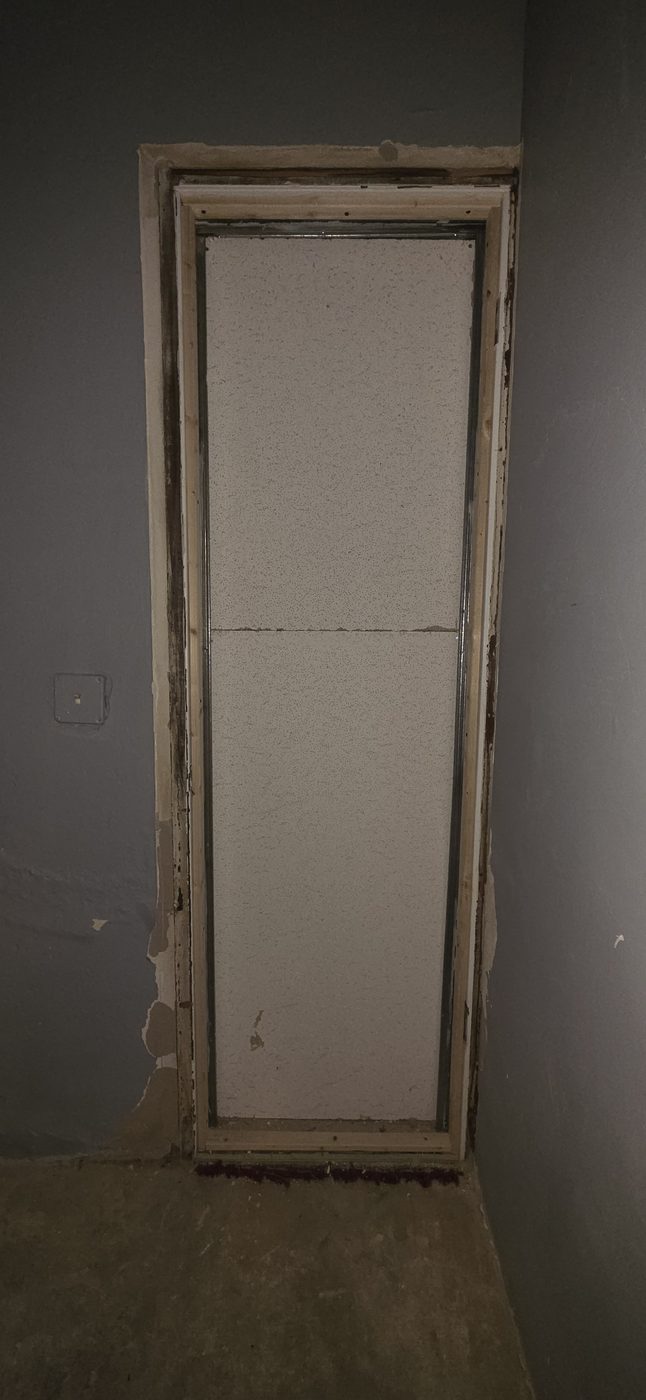

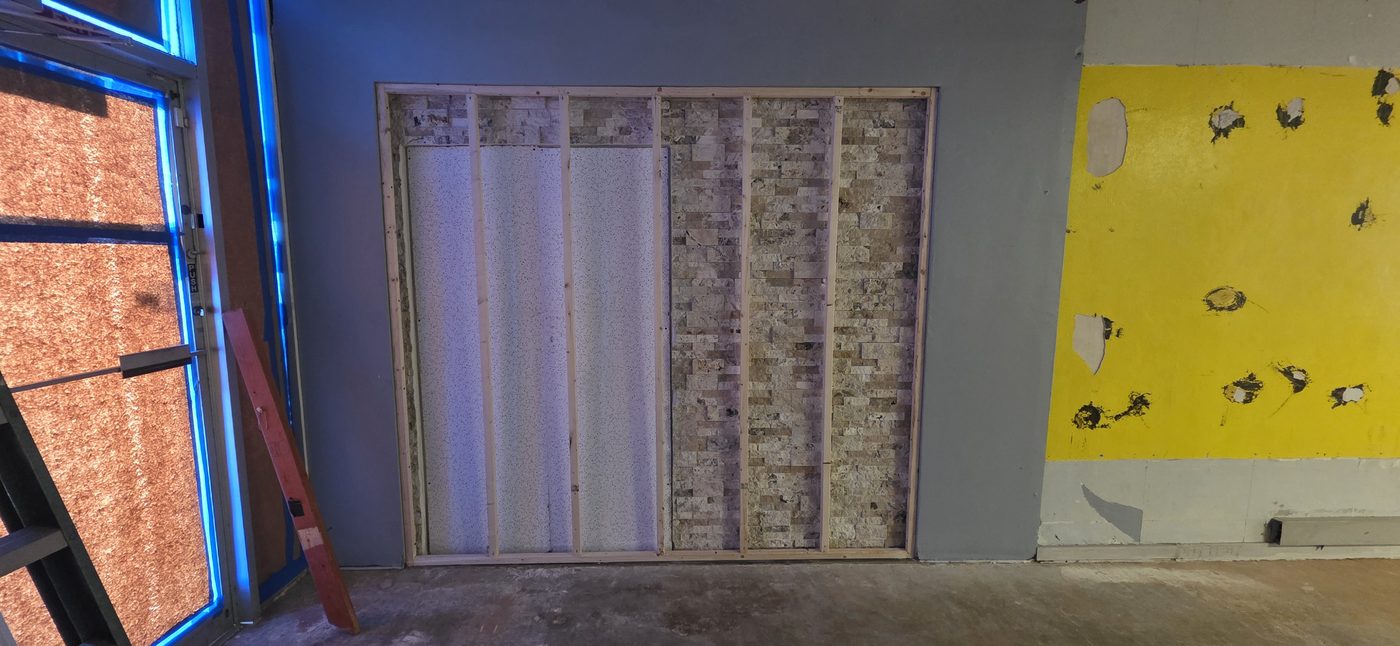

Existing Conditions Photo Gallery
Site reconnaissance · April 27, 2026 · click any photo to enlarge
Frank Adam Main Panel — Circuit Map
125A 1-phase 3-wire 120/240V · UL Listed Class N1 Issue 4808 · 16 of 20 slots used · 4 spare
SlotBreakerCircuit Description
120ABathroom Power
220ALighting
320ASingle Receptacle West Wall
420ATrack Lighting
520AReceptacles N Wall + Fans
620AReceptacles W Wall
720AReceptacle East Wall (middle)
820AEast Receptacle (south end)
9— SPARE —
10— SPARE —
1120AWest Receptacle (southernmost)
1220AOutside Lights
1315AReceptacle on NE Wall (only 15A in panel)
1420AWest Receptacle (NW)
1520Alabel faded — unverified
1620AEast Wall Receptacle (middle)
1720AReceptacle East Wall (south)
1820AEast Receptacle (north end)
19— SPARE —
20— SPARE —
Panel installed by Albert N. Siefert (EC0002423) per PM-08120788, December 2008.
Building Use History
≤ 2000
Gym — confirmed by mirror walls + ballet barres still in place + permit notation
Source: PM-00090327 HVAC permit notation "(GYM)" · on-site photos
1996–~2020
Realty Executives offices — 1,000 SF, 114-Offices class
Source: FS-23093230 Fire Safety Account · Inactive after 9/2020 violation
~2020–2026
Vacant ~5+ years
Source: FS-23093230 inactive status + lease commencement Feb 2026
2026 →
Awa Na Kava kava bar (Phase 1)
Source: Executed lease 2/1/2026
Existing Mechanical / Electrical Infrastructure

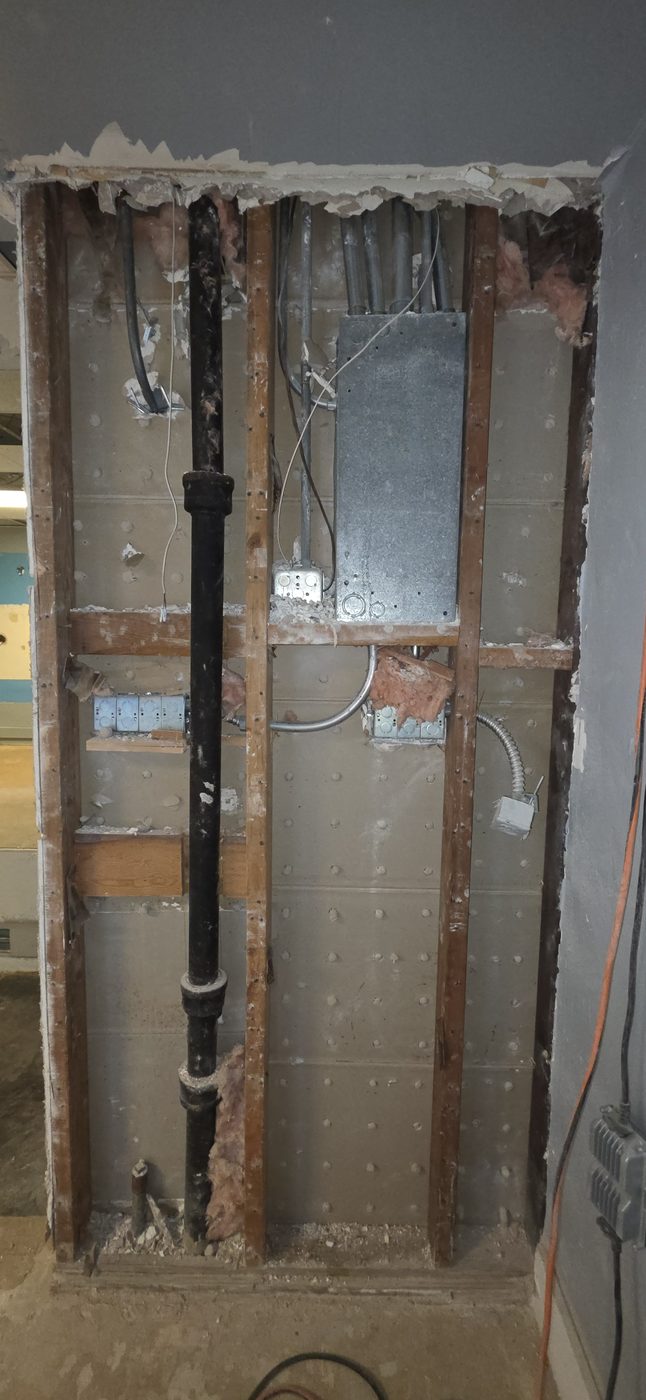

Main Panel
Frank Adam 125A · 16/20 used
Photos + PM-08120788

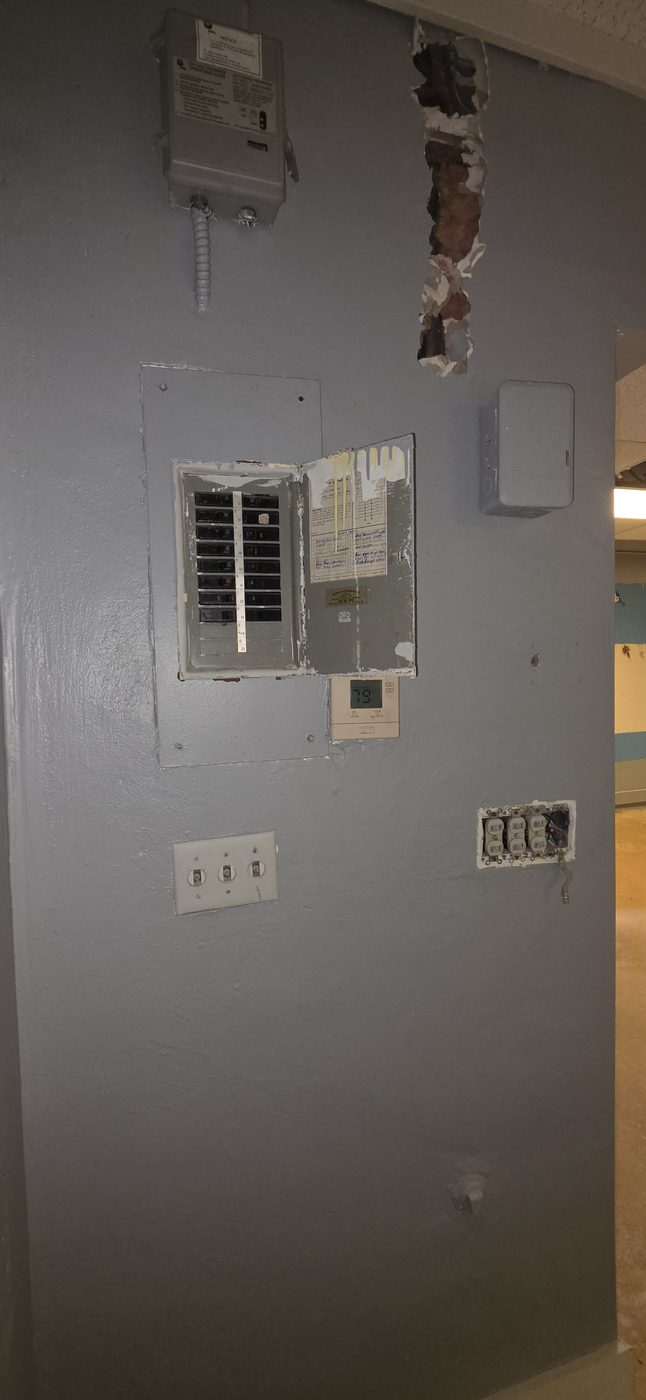

Second Panel
Utility room · capacity TBD
Photos · CI-03 pending
FPL Device
Type-31 Load Mgmt
Photos
Mechanical Timer
Intermatic-style · function TBD
Photos
HVAC
3-ton · 2000 install (26 yr) ⚠
PM-00090327
Bathroom Exhaust
Existing ceiling fan · functional
Photos · existing
Drop Ceiling
2x4 acoustic · disturbed (per directive)
Photos · Nick directive 4/27
Mirror Walls
Both E + W · DEMO scope (CI-05)
Photos · gym era

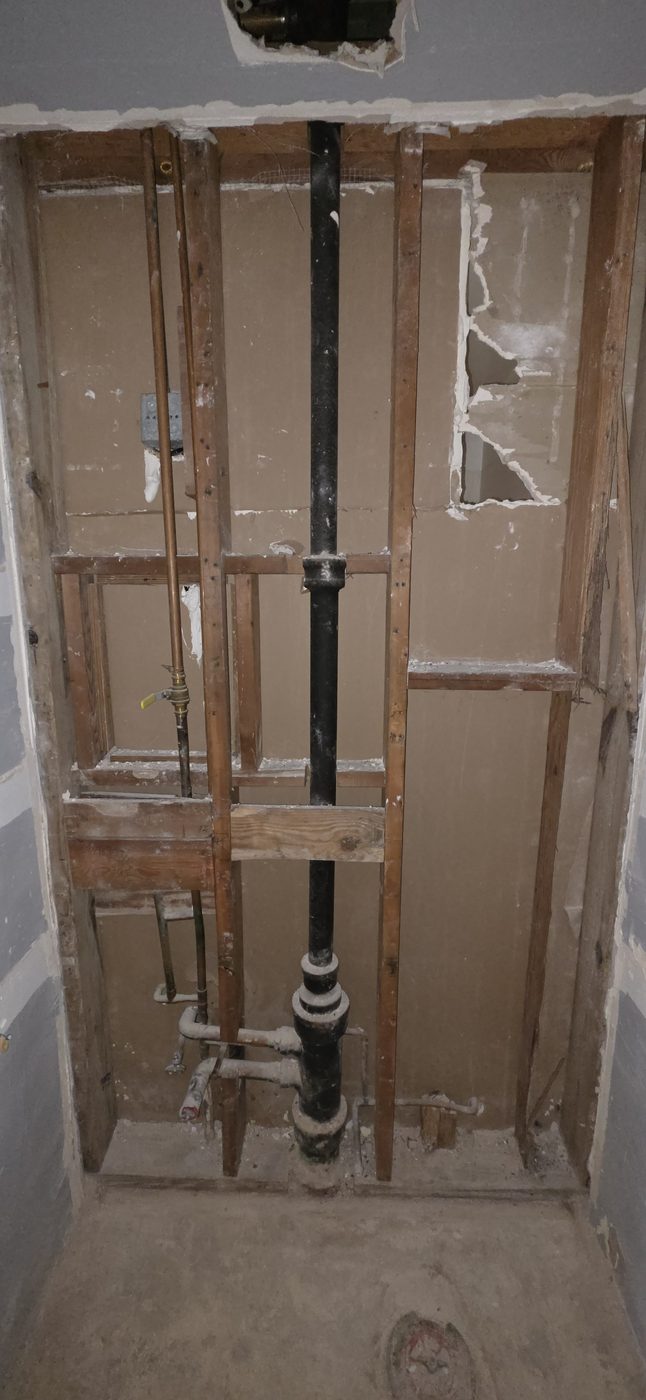

Existing Bathroom
Turn-key · toilet + vanity + fan + GFI
Photos
Handwash Sink
Owned · needs rough-in
Nick
3-Comp Sink
Owned · needs rough-in
Nick
Floor
Carpet REMOVED · concrete subfloor
Photos · concrete exposed
Permit History (LauderBuild)
DatePermit #TypeDescriptionStatus
2011-09-07PM-11090400Re-RoofReroof flat 3,743 SF · Manning/All American Roofing CCC045912 · $26,000Complete
2010-04-01PM-10040010Building RecertForty Year RecertificationComplete
2008-12-12PM-08120788ElectricalReplace 125A Main Disconnect · Albert Siefert EC0002423Complete
2000-09-07PM-00090327HVACReplace 3-ton unit, raise on stand (Gym) · Worrell/State Energy CAC056704Complete
2000-08-18PM-00081518Re-RoofReroof 9 SQ flat roof · Manning/All American Roofing CCC045912Complete
1996-11-25FS-23093230Fire SafetyRealty Executives · 1,000 SF · ABC 9/20 ext · NO sprinklers/smoke/standpipeInactive
Original PDF ↓
Lease & Landlord
Term
5 years from Feb 1, 2026
Rent Commencement
Apr 1, 2026
CAM
18%
Landlord Entity
2747 Oakland LLC
Landlord Contact
Kenneth Fisher
Property Mgr
Patti Franco
Lockbox
Rear gate · code 2751
Innovative Design Build, Inc.
General Contractor
Rick Doremus (President) · 954-592-9179 Brian LeTulle (VP) · 954-444-2902 Jim Diehl, PE (Engineer, route via Rick/Brian) · 954-297-5584
Brief Sent
Pending — 4/27 AM
Phone Confirmed
Pending
Walkthrough
Target: Thu PM/eve
Pricing
Pending
Timeline
Pending
Contract
Not signed
Deposit
Not paid
Drawings Stamped
Pending Jim Diehl

Scope Summary (from Brief v2)

  • General contractor coordination across plumbing, electrical, framing, finishes
  • Engineering drawings via Jim Diehl, PE — stamped to scope locked with Dan + Marcos
  • Permit application submission online via FTL Accela
  • Build sequencing and inspection coordination across 6 inspections + 6 gates
  • Phase 2 strategy note: Discuss feasibility of single-round permitting that includes DBPR plan review + indoor hookah service review in parallel with Phase 1, to enable single rollout vs phased rollout when Phase 1 is permit-ready

Linked Path Steps

  • Steps 9–12: Engineering drawings → permit drafting → permit submission
  • Steps 18–22: Inspection coordination (mechanical / framing / insulation / drywall screw)
  • Steps 23, 27: Finishes coordination + Final building inspection
  • Step 26: BADAACCESS inspection (separate, ADA verification)
Dan Berg
Plumbing — Oakland Park Plumbing
Brief Sent
Pending — 4/27 AM
Phone Confirmed
Pending
Walkthrough
Target: Thu AM joint w/ Marcos
CI-01 Test
Soil stack water test
Pricing
Pending
Timeline
Pending

Scope Summary (from Brief v2)

  • CI-01: Soil stack water test (verify drainage with garden hose adapter)
  • Hand wash sink rough-in (existing fixture, owned by Nick)
  • 3-compartment sink rough-in (existing fixture, owned by Nick)
  • Mop sink (FDACS Part 1 §10 required — hot water optional)
  • Existing bathroom (turn-key) — verify lavatory drain has air gap, backflow preventer adequate

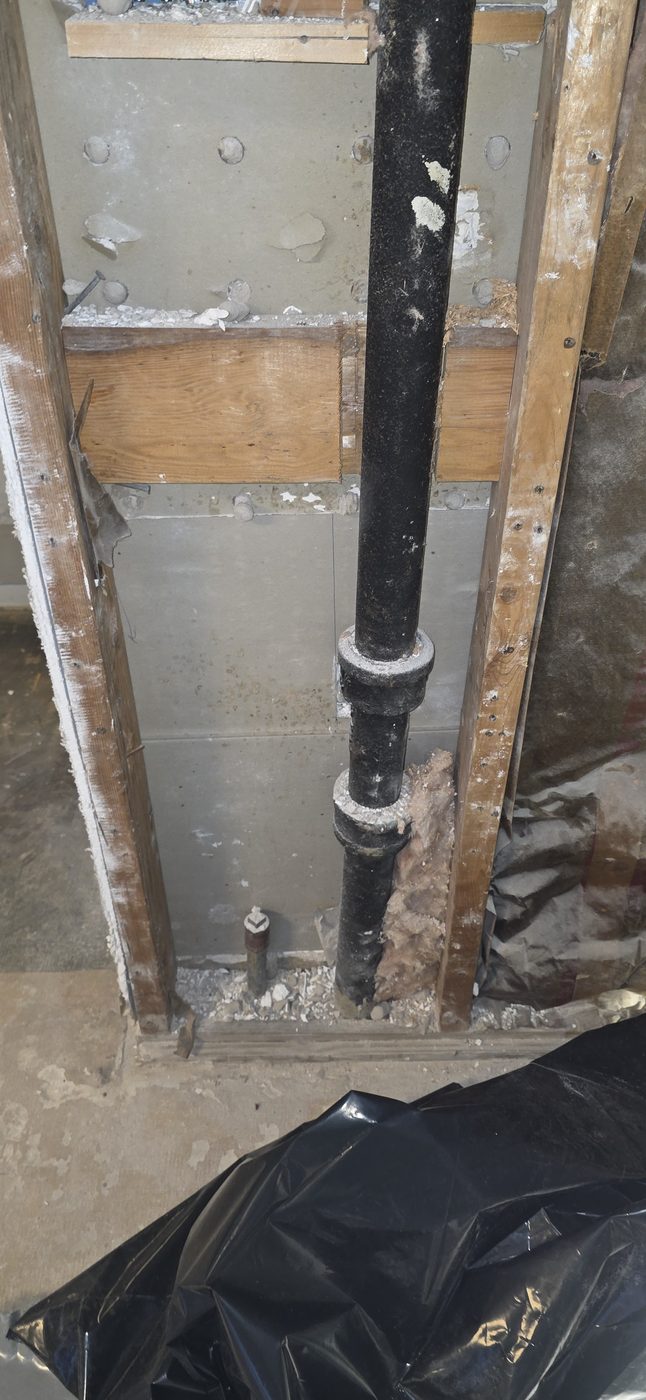

  • Use abandoned bathroom plumbing infrastructure where possible (existing drain + supply lines in attic)
Marcos Coelho
Electrical — S&R Electric
Brief Sent
Pending — 4/27 AM
Phone Confirmed
Pending
Walkthrough
Target: Thu AM joint w/ Dan
CI-03 Assessment
2nd panel utility room: capacity, source, function
CI-04 Capacity
125A capacity (4 spare slots — tight)
Pricing
Pending
Timeline
Pending

Scope Summary (from Brief v2 + Site Recon)

  • CI-03: Second panel in utility room — verify (a) source feed, (b) amperage capacity, (c) function, (d) active vs. abandoned
  • CI-04: Main panel 4 spare slots tight — kitchen build needs ~5 dedicated. Choose: consolidate, sub-panel, or service upgrade
  • FPL Type-31 Load Management Device — confirm doesn't constrain HVAC operation
  • Mechanical timer — identify what it controls (outdoor signage / lighting / HVAC), keep or remove
  • Existing Frank Adam panel (PM-08120788, Albert Siefert EC0002423, Dec 2008) — most recent licensed electrician of record on main service
  • Power requirements for build-out (Phase 1 menu: beverages + retail)
  • Lighting plan — keep existing track lighting (circuit 4) or replace? Exterior signage circuit (12)?
Open Risks & Issues
Live tracking · resolves auto-cascade to Dashboard
Discussion Board. Use this space for project questions, research findings, status updates, and team coordination. All posts are tagged with your name and timestamp. Newest posts appear at the top.
